Article Open Access1 January 2017

Selection of Rail System Projects with Analytic Hierarchy Process and Goal Programming

Order Reprints Cite Share

Mustafa HAMURCU*, Hacı Mehmet ALAĞAŞ, and Tamer EREN

* Author to whom correspondence should be addressed.

Sigma Journal of Engineering and Natural Sciences 2017, Vol. 8, Suppl. 4, pp. 291-302; doi.org/10.62051/ytu.sigma-journal-of-engineering-and-natural-sciences-selection-of-rail-system-projects-with-analytic-hierarchy-process-and-goal-progr

Download PDF

Abstract

Rail systems constitute the body of the public transport in cities. Suburban, tramway, light rail systems, metro and monorail systems are urban rail systems and participate in urban public transportation. In this context, large investments are made in railway systems in urban areas and urban transport is being tried to be improved. Istanbul Metropolitan Municipality, which realizes its investments with a service concept that can be an example to the world states, also makes and plans big investments in the field of rail systems. Managers aim to increase the quality of life of Istanbul by avoiding the traffic problem brought by the increasing population and urbanization in Istanbul with short, medium and long-term rail system plans. However, it is not possible to make every project. Projects that provide the most benefits within certain constraints and criteria such as the budget should be prioritized or selected. Multicriteria decision making techniques are widely used for project selection. In this context, in this study, the planned rail projects in Istanbul are selected under the different budget scenarios using the analytic hierarchy process and the goal programming method in an integrated manner.

Keywords: Multicriteria decision making; project selection; rail systems; transportation planning.

1. Introduction

In Istanbul, the existing rail systems are inadequate to meet the transportation demands, the population continues to increase and settlements are expanding. Due to such reasons, the time spent in traffic is increasing. At the same time, this affects the livability of the city. The request of passengers is to realize their daily journeys safely and comfortably in a short time. Highway traffic is increasing due to the fact that most of the journeys are made by road and the number of private cars is increasing. A lot of investment is made public transportation to reduce this density. Most of these investments are investments in rail systems, which are safe, comfortable and fast transport systems. With its short, medium and long-term plans, Istanbul is making and planning big investments in rail systems. It is aimed to reach to many points of the city by rail system such

Corresponding Author/Sorumlu Yazar: e-mail/e-ileti: hamurcu.mustafa.55@gmail.com, tel: (318) 357 42 42 / 1045

M. Hamurcu, H.M. Alağaş, T. Eren / Sigma J Eng & Nat Sci 8 (4), 291-302, 2017

as metro, tramway and monorail lines. In this context, there are many activities that are under construction, in the tender stage and in the projecting stage. To be able to respond to increasing passenger demands with the existing road network and public transportation systems in Istanbul, rail systems are planned on the whole city as efficient, fast, comfortable and safe means of transportation. In this study, the project selection for the planned railway system projects in the following years is discussed with three different budget scenarios. Types of rail transport systems are weighted by analytic hierarchy process (AHP), which is a multi-criteria decision-making method and the most suitable projects to be constructed are selected with the goal programming method. In the second section of the study, various types of rail systems are mentioned. AHP and goal programming methods are described in the third and fourth sections. In the fifth section, project selection problem is given. In the sixth section, the application and its results are mentioned. In the last section, the results and future works are given.

2. Urban RAIL Systems

In urban areas, suburban, tramway, light rail system, subway and monorail systems are preferred for public transport due to their high capacity, reliability and speed. The suburban trains are heavy rail systems that connect long distances with high capacity. Tramway is vehicle with the lowest capacity among rail systems. Metro is a type of urban transportation that provides public transport from underground with high capacity, reliability and speed. The monorail is an eco-friendly and recently popular means of public transport that travels along its own unique route, ascending from the ground atop the columns to the vehicle traffic. There are different monorail types as overlay type, suspension type and console type. The literature on rail systems and urban transport has been given under the section of project selection.

3. Analytic Hierarchy Process

Multi-criteria decision making (MCDM) methods are approaches that help to determine the most appropriate option among the alternatives in accordance with the determined criteria and targets. In this structure, criteria which are generally independent and expressed in different forms are taken into consideration. MCDA method of AHP and analytic network process (ANP), TOPSIS (Technique for Order Preference by Similarity to Ideal Solution), ELECTRE (Elimination meat Choix Traduisant la Reality), PROMETHEE (Preference Ranking Organization Method for Enrichment Evaluation) are frequently used. The general steps of the AHP method that is based on pairwise comparisons are as follows [1]; Step 1: Identifying the problem and establishing a hierarchy of goals, criteria and alternatives. Step 2: Pairwise comparisons between criteria and between alternatives according to each criterion Step 3: Normalize the generated comparison matrices and find the eigenvectors Step 4: Determine the weights of criteria and calculate a consistency value to determine the suitability of the decisions Step 5: Matrix multiplication of the importance ratings of the alternatives found for each criterion with the weights of the criterions and find the significance levels of the alternatives. Step 6: Order or selection of alternatives according to their importance

4. GOAL Programming

Problems encountered in daily life often have to be considered multiple objectives. Sometimes we want to accomplish many objectives simultaneously in the decision and sometimes we want to minimization of negative factors. In both cases, we use multi objective mathematical

Selection of Rail System Projects with Analytic Hierarchy … / Sigma J Eng & Nat Sci 8 (4), 291-302, 2017

models to achieve g oals in the same direction or conflict situations simultaneously in the realization of our purposes. Goal programming is also a kind of mathematical model and it tries to minimize the deviations from the goals by turning all of the goals into constraints [2]. Goal programming formulation as below; Objective Function: ,

Pi: priority, wi: weight, di+: Positive deviation di-: Negative deviation, aij: parameters ve xj: decision variables. Goal programming first addressed by Charnes and Cooper [3]. It is used in many areas such as transportation problems [4-7], production planning [8], resource planning in hospitals [9], project selection and management [10-11], marketing [12], menu planning problems [13], investment planning [14], job evaluation [15], media [16].

5. Project Selection Problem

Project selection problem is defined as the selection, sorting or weighting of one or several of alternative projects and it is the evaluation period of the most useful, best or least costly project. In selecting a project, we have more than one goal to make the right decisions. Such as, providing the highest benefit, selecting projects that are the shortest time or least costly. In the selection of the project, there is a need for mathematical tools to integrate many objectives into a single objective. At this point, multicriteria decision making methods and goal programming method that provides multi-objective mathematical modeling are at the forefront as analytical methods. In this study, AHP which is a multi-criteria decision-making method, and goal programming as a mathematical model are also used. There are many project selection studies in which these two methods are integrated. AHP and goal programming methods are used together in different areas such as selection of information system projects [17], resource use [18], quality control systems [19], supplier selection [20] and transportation [6], [11]. In urban transport, many studies have been done on project selection. Some of those; Kosijer et al. [21] in the selection of the best railway route, Mohajeri and Amin [22], in the selection of the railway station station, Gerçek et al. [23] assessed the best rail access network, Banai [24], light rail access corridor and alternative routes, Macura et al. [25], order of railway infrastructure investment projects, Abastante and Lami [26] evaluation of transportation infrastructure strategies, Hamurcu and Eren [27-29] selection of monorail projects in Ankara. Taş et al. [30] and Hamurcu et al. [7] selection of monorail projects for urban transport in Ankara, Hamurcu and Eren [31] selection of urban transportation type, Hamurcu and Eren [32] project selection sustainable urban transportation, Kalamaras et al. [33], Piantanakulchai and Saengkhao [34], Piantanakulchai [35], Effat and Hassan [36], the highway route; Zhongzhen and Hayashi [37], rail system route; Yao [38], Farkas [39], Brunner et al. [40], public transportation route; Kim et al. [41] highway network planning.

6. Application

Istanbul is one of the metropolitan cities with its high population, expanding urban borders and ever-increasing economic development. Many problems arise in the city due to the increase in population and in-city journeys. At the beginning of these problems is the urban transportation

M. Hamurcu, H.M. Alağaş, T. Eren / Sigma J Eng & Nat Sci 8 (4), 291-302, 2017

problem. Variability in passenger density and population growth in the coming years will require continual addressing of these problems. District-based distributions of the journey are shown in Figure 1 [42].

Figure 1. Population by Provinces (1), Special Journey Production Areas by Provinces (2) and District - based (3) Distribution of Journeys, in Istanbul in 2023 Istanbul, which is the locomotive for other cities along with Ankara in the transportation area in our country, competes with and sometimes pioneers the metropolitan cities of the world with its huge projects. Managers who have signed many projects in urban transportation as well as many other areas, are planning to establish a rail system network throughout the city with various types and features of railed system projects. The railed systems in Istanbul on the basis of periods are shown in Figure 2 [42]. The goal of the Metropolitan city is to reach a rail system network about 1000 km of rail systems after 2019 with new projects.

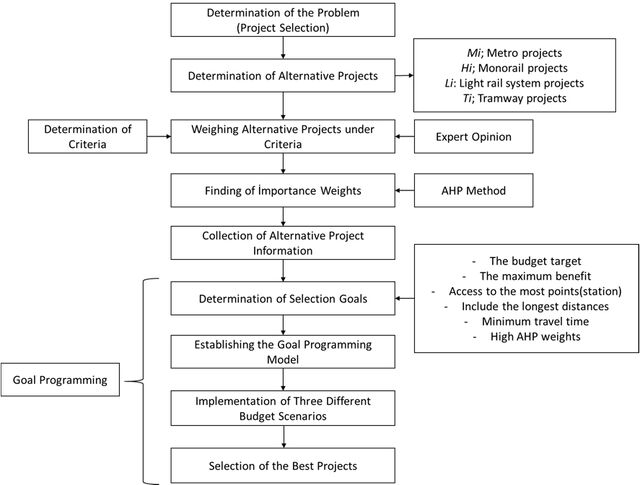

6.1. Research Methodology

When the problem of project selection is considered, firstly alternatives are determined and classified according to transportation type. Projects are divided into groups according to the

Selection of Rail System Projects with Analytic Hierarchy … / Sigma J Eng & Nat Sci 8 (4), 291-302, 2017

transportation method by using opinion of urban transport planning department experts and literature. Each group is weighted according to the criteria of capacity, safety, speed, prestige and cost. The AHP method is used for weighting. Goals are set as the budget goal, maximum benefit, linking the most points, combining the longest distances, least travel time and high AHP weighting. Determinated our aims are rail system and urban transport goals of Istanbul Metropolitan Municipality that are maximum benefit, access to most stations, access to the longest areas, providing minimum travel time and using minimum budget. Three different scenarios are solved with the goal programming method using the specified goals and the best projects were selected. The process flow chart is given in Figure 3.

6.2. Determining Alternative Projects

The projects to be planned are the subway, tramway, monorail and light rail system projects considered within the borders of Istanbul Metropolitan Municipality. Alternative projects and properties are shown in Table 1.

M. Hamurcu, H.M. Alağaş, T. Eren / Sigma J Eng & Nat Sci 8 (4), 291-302, 2017

Selection of Rail System Projects with Analytic Hierarchy … / Sigma J Eng & Nat Sci 8 (4), 291-302, 2017

6.3. The Weighting of Transport Types

Rail system projects are selected from 4 different transportation types. These types of transportation are metro, monorail, light rail system and tramway. These systems, which have different characteristics, are weighted according to safety, capacity, speed, cost and prestige criteria. Table 2 shows the pairwise comparison matrix of the criteria. The criterion weights obtained as a result of pairwise comparisons are given in the weight column in table 2. For each type of transportation, pairwise comparisons are made according to each criterion and their weights are shown in Table 3 on a criterion basis. Table 2. Pairwise Comparison Matrix of Criteria and Weights of Criteria Security

The Consistency Ratio: 0,08044 Table 3. Criteria Weights of Transportation Types Security

The criterial weights of each transportation type are multiplied by the criterion weights in Table 2 and these values are summed to obtain final weights of transportation systems (Table 4). Table 4. Importance Weights of Transportation Types

6.4. Mathematical Model of Problem

The goal programming model is established that collects different objectives under one objective for the problem. There are multiple goals in the problem, such as achieving the budget goal, making the most of the benefits, linking the most points, combining the longest distances,

M. Hamurcu, H.M. Alağaş, T. Eren / Sigma J Eng & Nat Sci 8 (4), 291-302, 2017

and achieving the minimum travel time objectives. Maximization of the weights obtained with AHP is also one of the goal. Goal programming model of the problem is given in Table 5. In the mathematical model, the objective function of which deviations from the targets are minimized is defined as meeting mandatory objectives, ensuring high AHP weights and ensuring budget constraints. The constraints consist of providing the most benefit, accessing the most stations, combining long distances, ensuring minimum travel time, mandatory selection of M3 and M19 metro projects, and selection of all alternative projects.

6.5. Solution Results

The mathematical model is solved separately for three different budget scenarios with IBM ILOG CPLEX 12.6.2 program and the solution results are given in Table 6. Table 5. Mathematical Formulation Mathematical Model Model formulation

Select Project H1 Select Project H2 Select Project L1 Select Project L2

Selection of Rail System Projects with Analytic Hierarchy … / Sigma J Eng & Nat Sci 8 (4), 291-302, 2017

Select Project L3 Select Project L4 Select Project L5 Select Project T1 Select Project T2 Select Project M1

Hi=0 veya 1 (i=1,2) Ti=0 veya 1 (i=1,2) Li=0 veya 1 (i=1,2,3,4,5) Mi=0 veya 1 (i=1,2,3,…,21)

Table 6. The Three Different Budget Scenarios and Results of Solution Projects 150 The budget scenarios 100 (Billions $*100) 80 Projects The budget scenarios (Billions $)

M16 M17 M18 M19 M20 M21

According to the $ 15 billion budget scenario, 12 metro projects, 1 tramway project, 1 monorail project and 2 light railway system projects are selected. According to the $ 10 billion budget scenario, 9 metro projects, 1 tramway project and 1 light rail system project are selected. Finally, according to a budget scenario of $ 8 billion, 7 metro projects and 1 light rail system project are selected.

6.6. Conclusions and suggestions

In this study, railed system projects which are planned in Istanbul are selected by establishing the goal programming model under certain constraints. The types of rail system are weighted with AHP from multicriteria decision making methods. According to the criteria of security, capacity,

M. Hamurcu, H.M. Alağaş, T. Eren / Sigma J Eng & Nat Sci 8 (4), 291-302, 2017

speed, cost and prestige, the types of rail systems are weighted with AHP. The metro, monorail, light rail system and trolley preference order emerged with the safety criterion considered to be the highest weight. Subsequently, the best projects were selected to improve urban transport among the planned transportation projects with the mathematical model established at the point of achieving the specified objectives. Urban transportation planning is one of the most difficult decision-making processes of transportation planning. Using mathematical calculations has become compulsory in order to achieve the highest profit by using available resources. The use of mathematical methods makes it possible to achieve many goals at the same time. Solving the problem with a mathematical model will ensure that projects are best selected for a more liveable city and less traffic. These methods, which are used in many areas, also have an effective use in transportation planning. In urban transport projects, many factors must be taken into consideration and scarce resources should be used effectively. These methods can be used in the selection of vehicle type in urban transportation, in the selection of investment projects, in route setting, prioritization of infrastructure projects, transportation network planning, and allocation of resources to projects. Thus, the projects and activities that will be the most beneficial will be selected and prioritized by providing the resource utilization activity.

Share and Cite

HAMURCU, M.; ALAĞAŞ, H.M.; EREN, T. Selection of Rail System Projects with Analytic Hierarchy Process and Goal Programming. Sigma Journal of Engineering and Natural Sciences 2017, Vol. 8, pp. 291-302. https://doi.org/10.62051/ytu.sigma-journal-of-engineering-and-natural-sciences-selection-of-rail-system-projects-with-analytic-hierarchy-process-and-goal-progr

Export:

Related Articles

An Investigation of High Speed Transport Systems Design and GeodynamicsSetenay Akça and Mehmet Fatih Altan, 1 January 2021Selection of Monorail Technology By Using Multicriteria Decision MakingMustafa HAMURCU, Tamer EREN, 1 January 2017Analytic network process and TOPSIS methods with selection of optimal investment strategyİnci GÖRGÜLÜ, Melek KORKMAZ et al., 1 January 2013A new approach of gluten derivatives for activity as theoreticalFaik GÖKALP, 1 January 2017
Publication History
Published1 January 2017
Versionv1
AccessOpen Access
10.62051/ytu.sigma-journal-of-engineering-and-natural-sciences-selection-of-rail-system-projects-with-analytic-hierarchy-process-and-goal-progr
Article Figures (4)
Figure 1Figure 2Figure 3Figure 4
Related Articles
An Investigation of High Speed Transport Systems Design and GeodynamicsSetenay Akça and Mehmet Fatih AltanSigma Journal of Engineering and Natural Sciences, 1 January 2021Selection of Monorail Technology By Using Multicriteria Decision MakingMustafa HAMURCU, Tamer ERENSigma Journal of Engineering and Natural Sciences, 1 January 2017Analytic network process and TOPSIS methods with selection of optimal investment strategyİnci GÖRGÜLÜ, Melek KORKMAZ et al.Sigma Journal of Engineering and Natural Sciences, 1 January 2013
Sigma Journal of Engineering and Natural Sciences coverSigma Journal of Engineering and Natural Sciences Download PDF

Subscribe to YTUP

Stay connected and receive the latest research updates directly in your inbox.

YTUP — Yıldız Technical University Publishing

Advancing knowledge and fostering innovation through high-quality, peer-reviewed academic publications.

About YTU

Discover

  • ›Articles
  • ›Journals
  • ›Research Topics
  • ›Open Access Policy

Guidelines

  • ›Author guidelines
  • ›Services for authors
  • ›Policies and publication ethics
  • ›Editor guidelines
  • ›Fee policy

Explore

  • ›Articles
  • ›Research Topics
  • ›Journals
  • ›How we publish

Support

  • ›Help center
  • ›Emails and alerts
  • ›Contact us
  • ›Submit
  • ›Career opportunities
YTU Logo

© 2026 Yıldız Technical University (Istanbul, Turkey)

Terms and ConditionsTerms of UsePrivacy PolicyPrivacy SettingsDisclaimer
Like this platform? Join our teamHave feedback or questions?
Supervisor
